34 Portland Place and 73 New Cavendish Street form an adjoining diplomatic complex in the heart of Marylebone. The commission combines the restoration of an exceptional Grade II* Portland Place townhouse with a Grade II building addressing New Cavendish Street. Together the buildings extend to more than 2,000 sqm and had remained vacant for over a decade, with significant areas of deteriorated fabric and obsolete building services. The project will return the complex to long-term diplomatic and cultural use, including an official Ambassador's residence and representative accommodation at 34 Portland Place, together with cultural and diplomatic functions at 73 New Cavendish Street. Cohanim's role extends far beyond architectural design. We lead and coordinate the interface between conservation, planning, structure, MEP, fire engineering, accessibility, acoustics, health and safety, specialist fabric analysis, Party Wall legislation, neighbouring property interests, Building Control, the Freeholder and the Contracting Authority. The project records confirm Cohanim's appointment as lead architect within the consortium and identify the Contracting Authority, Freeholder and principal statutory consultees.
Restoring two buildings while creating one functioning diplomatic complex The brief combines a series of uses with very different spatial and technical requirements. 34 Portland Place is being returned to use as the official Ambassador's residence, together with formal reception, diplomatic and guest spaces. 73 New Cavendish Street is being transformed to accommodate a Cultural Institute alongside diplomatic functions. The buildings are physically interconnected but architecturally very different. No.34 is an exceptional historic townhouse forming part of a Grade II* Portland Place terrace. No.73 contains substantially more later fabric and a complex history of alteration. The challenge is therefore not to impose one architectural solution across both buildings, but to understand the significance and capabilities of each part of the estate and coordinate them into a coherent operational whole.
Architecture within a network of overlapping rights and approvals Very few individual design decisions at this project exist in isolation. A new opening may involve listed fabric, structure, Party Wall legislation and an adjoining owner. A service route may affect historic plasterwork, structural beams, fire compartmentation, ceiling heights and the Freeholder's requirements. A means-of-escape proposal cannot be considered solely within the Contracting Authority's two properties because an historic reciprocal escape arrangement connects the project to a third building at 36 Portland Place, occupied by a school. A new lift involves heritage, structure, accessibility, fire safety, Party Wall considerations and potentially underpinning. The project has consequently required architecture to operate as the central coordinating discipline between a very large number of technical, legal and stakeholder interfaces.

34 Portland Place is a Grade II* listed townhouse forming part of the grand Portland Place composition. It retains important historic spatial and decorative characteristics but has also experienced repeated interventions which disrupted its original plan form, historic interiors and relationship with adjoining properties. 73 New Cavendish Street is Grade II listed but considerably more complex in construction history. Significant portions above ground were reconstructed during the 20th century, while other areas retain earlier fabric including basement vaults. The buildings are currently linked at basement, ground and first-floor levels. The planning strategy therefore considers both their individual significance and their collective operation.
A defining characteristic of the project has been the depth of investigation undertaken before finalising the design. The statutory submission has been supported by an unusually wide body of specialist evidence, including archival planning research, room-by-room heritage significance assessment, detailed condition surveys, historical paint analysis, mortar analysis, timber diagnostics, structural investigation, point-cloud and measured survey, drone/UAV survey, acoustic assessment, drainage surveys and CCTV investigation, management and hazardous-material surveys, and mould and mycological investigation. The planning documentation formally identifies historical paint analysis, mortar analysis, timber investigation, structural engineering, noise assessment and heritage condition work as part of the evidence base. This allows the project to distinguish between genuinely significant historic fabric and inappropriate or expendable later interventions.

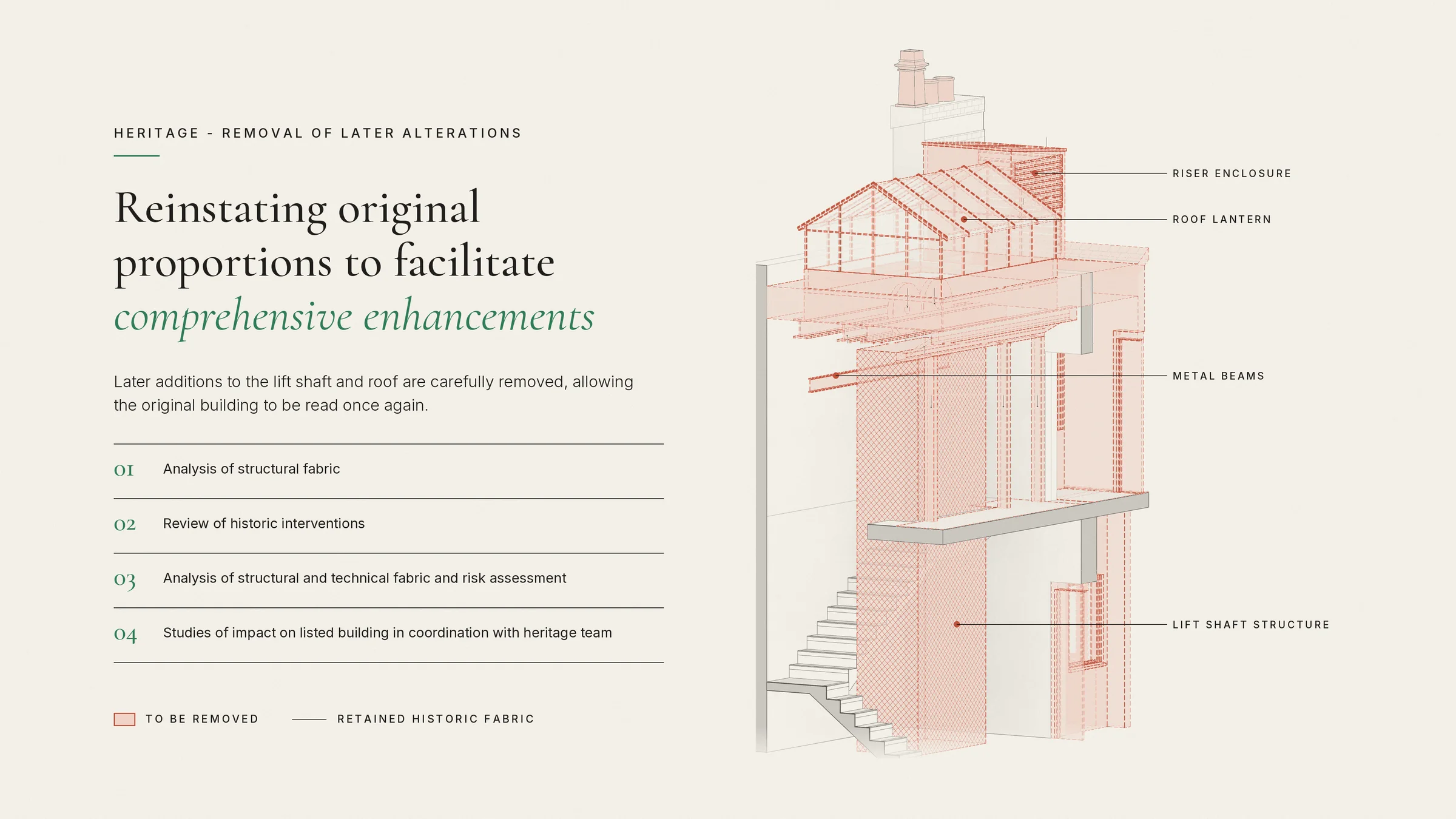

At 34 Portland Place, a major objective is to recover the legibility and hierarchy of the original townhouse. The proposals include the reinstatement of principal rooms, removal of unsympathetic later subdivisions, recovery of historic openings and improvement of the relationship between principal and subsidiary spaces. A Georgian enfilade is being restored, individual principal rooms are being returned to their original proportions and lost architectural details are being reconsidered using documentary evidence. The project also proposes a historically appropriate fireplace where one had been entirely removed and the reinstatement of an Adam-style ceiling for which archival evidence survives. The objective is not stylistic reproduction for its own sake. It is to restore architectural hierarchy where evidence makes that restoration defensible.

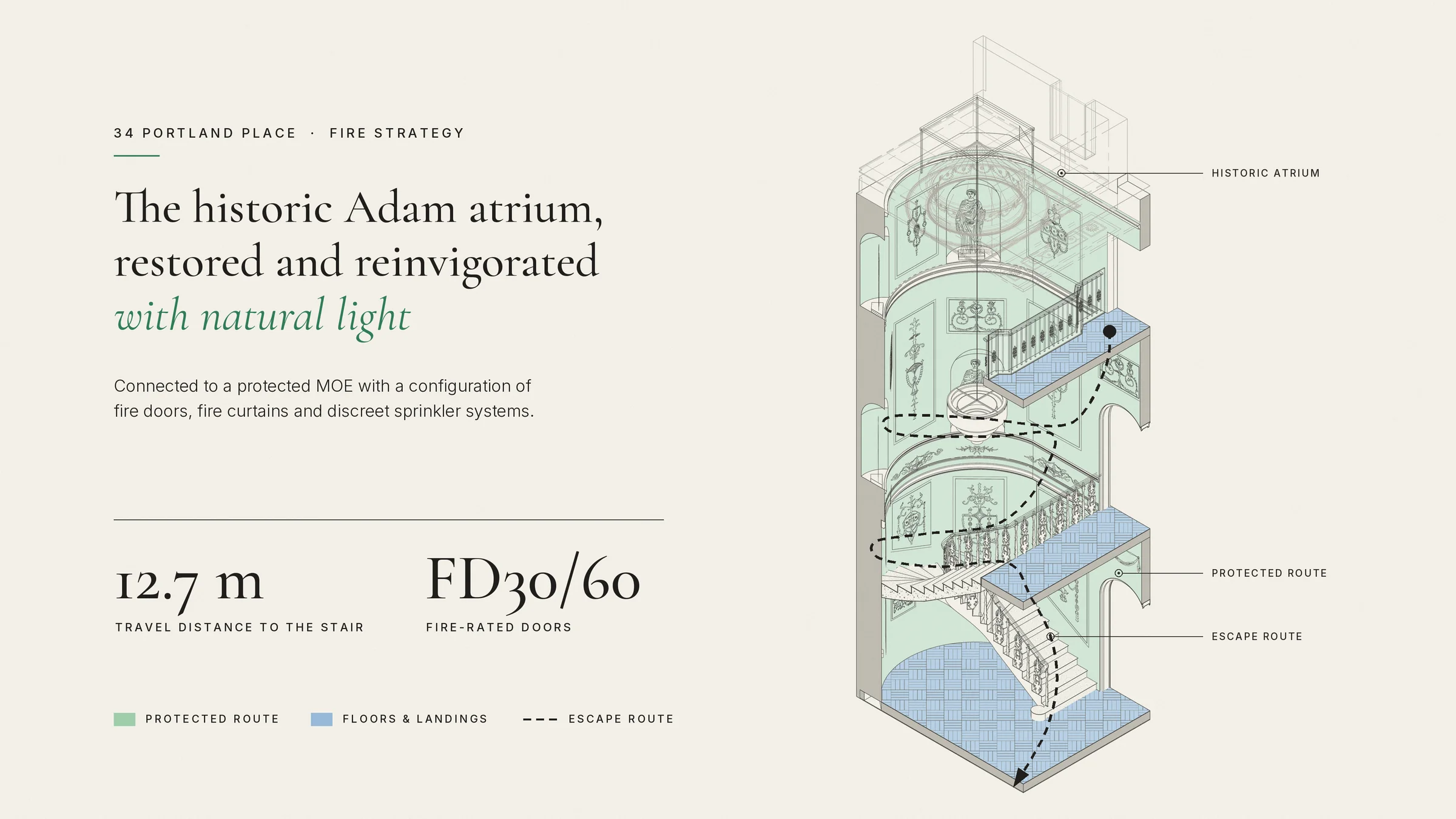

Fire engineering is one of the project's most technically significant workstreams. Although the primary project comprises 34 Portland Place and 73 New Cavendish Street, the historic means-of-escape arrangements connect the scheme directly with 36 Portland Place, meaning that life-safety strategy, neighbouring interests and implementation sequencing extend across three buildings. The existing reciprocal escape arrangement between 34 and 36 Portland Place is proposed to be removed and the original separation between the properties reinstated, requiring coordination not only with the project's own fire engineers and Building Control adviser but also with the Freeholder, neighbouring occupiers and separately appointed fire advisers reviewing the adjoining property. Conventional compliance solutions can themselves create significant harm in historic buildings, so the fire strategy also considered alternative suppression systems and the consequences of introducing extensive new pipework through important ceilings and decorative fabric. The design team progressed a water-mist suppression strategy as an alternative to conventional sprinklers, supported by enhanced compartmentation, protected escape routes and performance-based justification. By February 2026, Building Control had indicated in-principle acceptance of a water-mist approach subject to the required technical and heritage justification, and the project has continued independent specialist review of this position, including an additional fire-regulations meeting in August 2026 to verify the proposed approach and its regulatory basis.
The Party Wall work has become a project in its own right. A specialist Party Wall surveyor was appointed at an early stage, and potentially notifiable works were mapped across the complex before construction information was complete so that neighbour engagement could begin without creating avoidable programme delay. The assessment considers numerous interfaces, including basement works adjoining neighbouring properties, work affecting party structures, new and altered structural openings, stair construction, drainage and service routes, removal and infilling of historic connections, means-of-escape alterations between 34 and 36 Portland Place, removal of significant existing steelwork, lift and lift-pit works, roof-level interfaces, and works within the influence of neighbouring structures. The Party Wall consultant's formal review identifies several different statutory triggers and multiple adjoining ownership interests requiring consideration. The neighbouring-property work extends beyond serving statutory notices. Certain design matters depend upon cooperation between the Contracting Authority, Howard de Walden Estate, adjoining leaseholders and occupiers - in particular the historic means-of-escape relationship with 36 Portland Place, which requires improving fire safety, reinstating the proper physical separation of the historic buildings and avoiding prejudice to the operation of the neighbouring school. We are not merely preparing Party Wall drawings; we are managing the architectural consequences of adjoining ownership, occupation and legal rights.

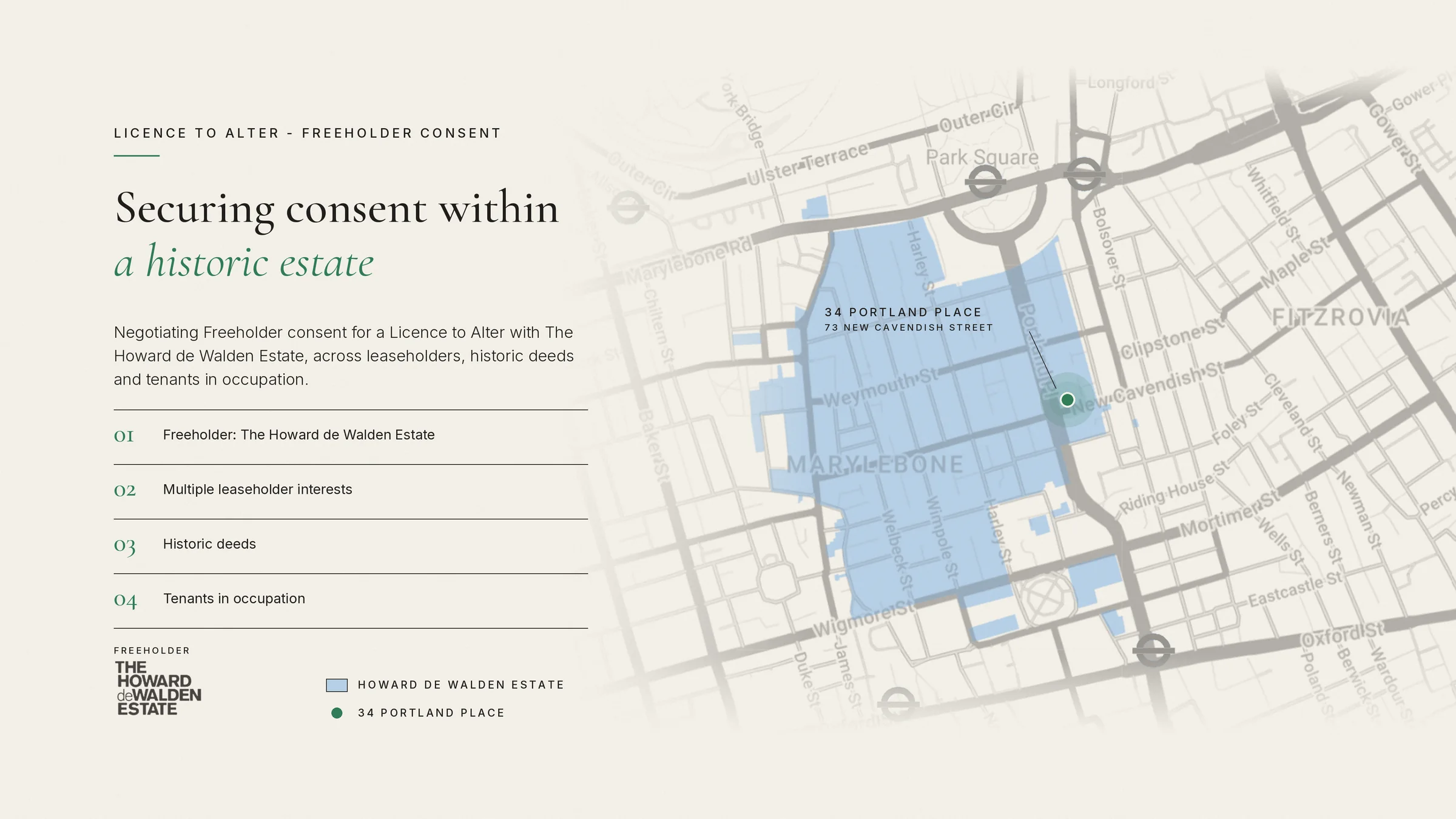

The Howard de Walden Estate is the Freeholder of the site, so a separate Licence to Alter process sits alongside the Westminster planning and Listed Building Consent process. Cohanim has been coordinating information - architectural drawings, fire and means-of-escape information, technical proposals and matters affecting adjoining properties - so that statutory and Freeholder reviews can progress in parallel rather than sequentially. The project reports record continuing Freeholder review, board approval requirements and fire-safety review as active project dependencies.
The scheme requires detailed planning and Listed Building Consent engagement with Westminster City Council. Pre-application engagement included an officer site visit in April 2025, with the developing proposals viewed positively and historic precedent identified for elements of the proposed fenestration. The project then encountered an unusual external challenge when Westminster's systems were affected by a significant cyber incident, delaying access to internal planning records and contributing to an extended pre-application and validation process. Rather than allowing the application to stall, Cohanim maintained direct officer contact, reissued information where necessary, assisted with document access and continued to press for formal engagement, culminating in direct meetings between Westminster, the Contracting Authority and the design team during 2026. The project has also involved specialist heritage consultees outside the Local Planning Authority. The Georgian Group visited the site and formally commended the high level of research and detail provided in relation to 34 Portland Place, recognising the heritage benefits of the wider restoration scheme and supporting the replacement of later windows with more historically appropriate alternatives where the evidence demonstrated that the existing windows did not contribute to the building's significance. Historic England has also formed part of the statutory-consultee strategy.

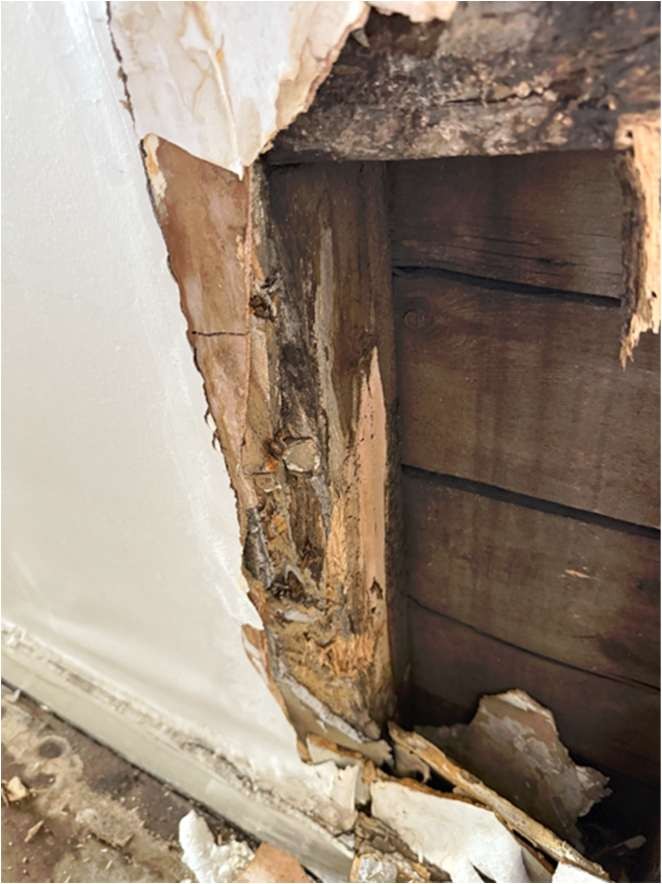

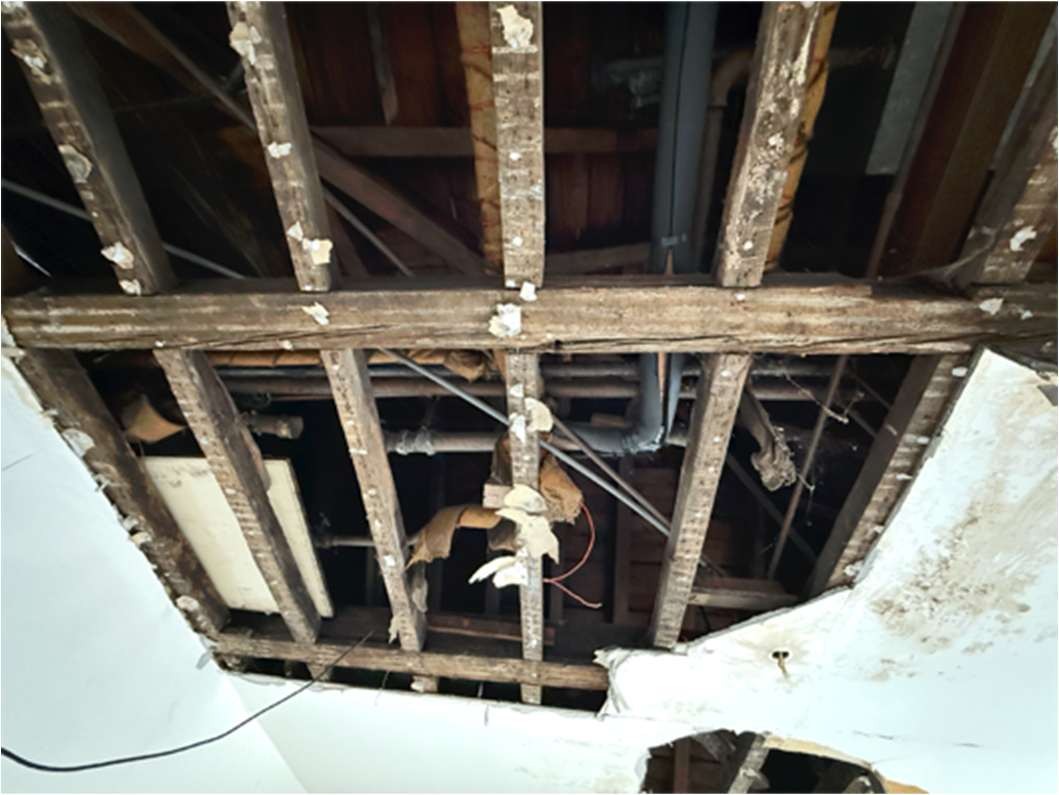

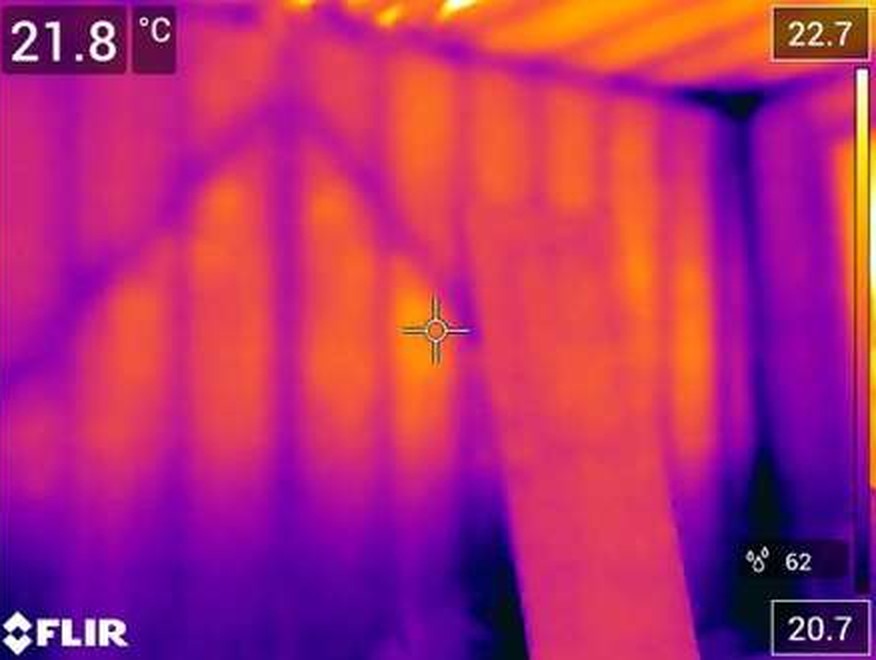

Health and safety investigation began during the earliest project stages. The specialist consultant register includes Eton Group for management survey work and damp / mycological investigation, and the project archive contains dedicated management-survey, mould-survey and asbestos-remediation documentation. This work has allowed hazardous materials, moisture, mould and existing-condition risks to be considered as part of the design rather than being left as contractor-stage surprises. The early action records also show investigation of historical asbestos records, confirmation of previous remediation, consultation with hazardous-material specialists and separate damp / mycological appointments from the opening weeks of the project.

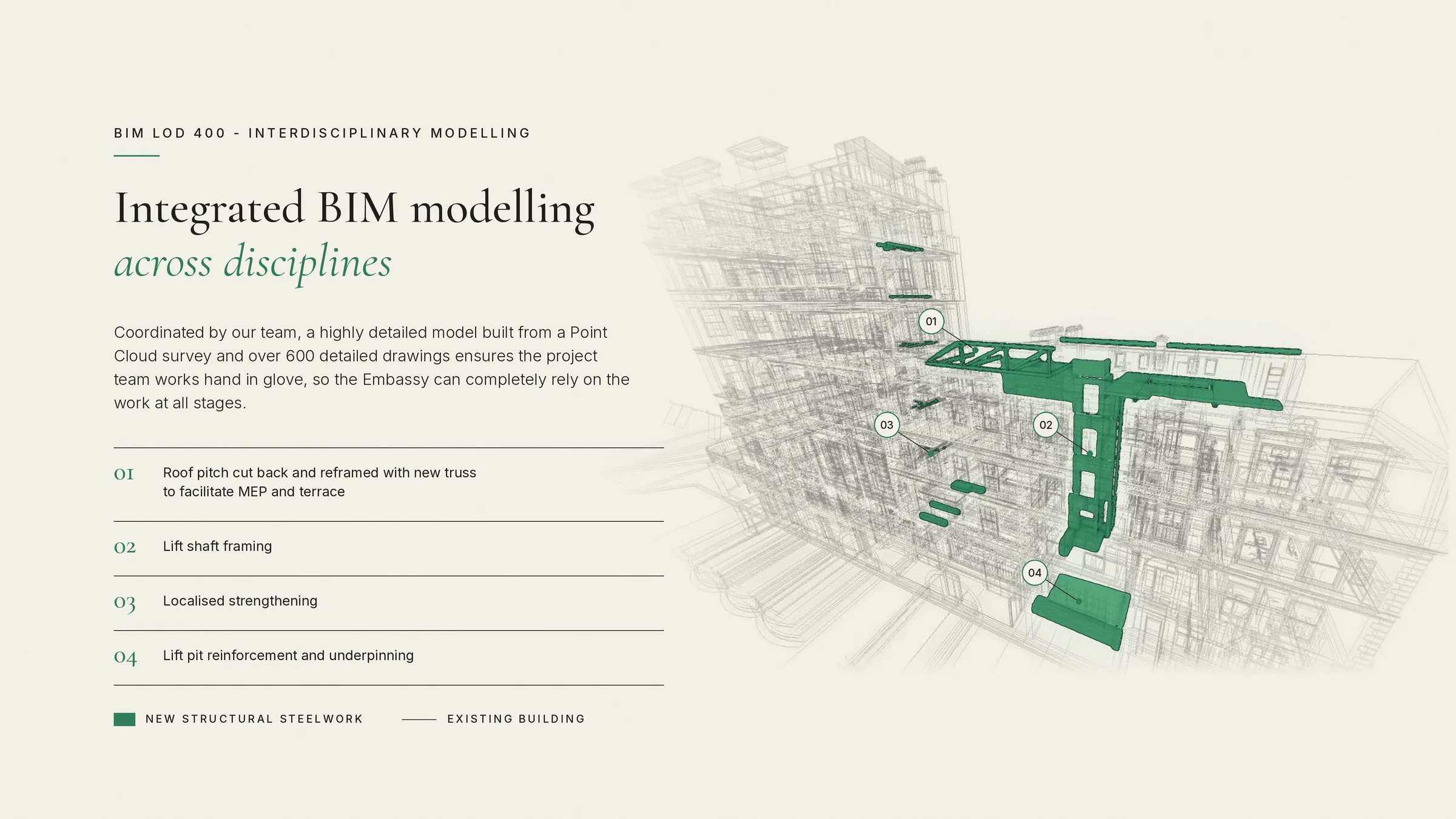

Existing listed buildings rarely conform neatly to modern drawings, so structural design has developed alongside surveys, opening-up and continuing site verification. The Stage 4 work includes new and altered openings, local strengthening, riser interfaces, roof structures, lift shafts and pits, existing steelwork, basement interventions and the relationship of new services with historic structure. Many of these elements simultaneously engage heritage and Party Wall considerations. The project is consequently being designed iteratively: survey, model, inspect, coordinate, verify and then detail.
The existing services had reached or passed the end of their practical operational life. A complete services strategy has therefore been developed across mechanical, electrical, public health, lighting, fire alarm, security, suppression, gas, water and associated systems. By August 2026, the architectural review register included coordinated packages for lighting and fire alarm, mechanical services, public health and water, schematics, small power, gas, security and sprinkler services. Rather than simply lowering whole ceilings to accommodate ductwork, the design team has repeatedly reviewed service routes, perimeter zones, localised bulkheads and plant positions to protect ceiling heights in the principal spaces - an approach documented in the February 2026 progress record across reception, office and multifunctional rooms, including localised service zones designed specifically to avoid unnecessary reductions in ceiling height. The objective throughout is to use later voids, less significant fabric and existing service zones wherever possible so that improved performance does not come at the expense of the historic interiors.

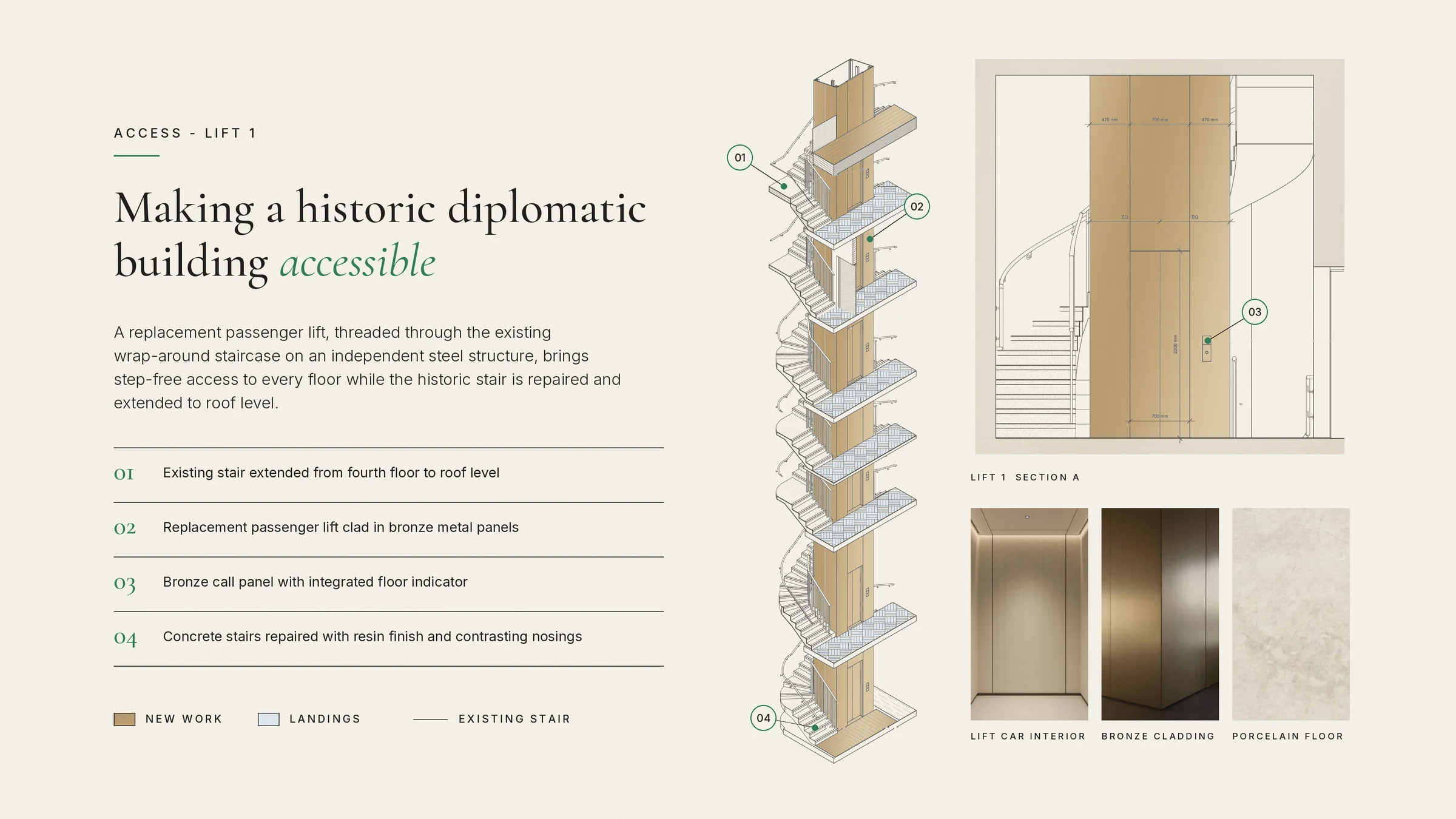

Inclusive access is another major part of the project. The wider strategy includes accessible WC provision, improved entrance arrangements and new lift infrastructure. At 73 New Cavendish Street, a new passenger lift is proposed within later fabric to provide substantially improved step-free circulation while reducing the impact upon significant historic material. Lift works have required their own coordination across structure, Party Wall considerations, Building Control, fire strategy and specialist lift design.
The project has also required detailed work on infrastructure which is largely invisible in the final architecture. CCTV drainage investigation, roof-water surveys and physical inspections have been used to establish existing routes, condition and reuse potential. Further coordination has included UK Power Networks capacity and connection requirements, water-service upgrades, gas-service upgrades, roof drainage, public-health services and the responsibility interfaces between utility providers and the future contractor. The June 2026 project record confirms continuing water, gas and power coordination alongside the principal Stage 4 design.
The project also has a governance layer which is unusual for a conventional private refurbishment. Cohanim works within a consortium and reports to an overseas governmental Contracting Authority. Project information has consequently been prepared and managed across UK statutory requirements while also responding to the Contracting Authority's own governance and procurement procedures. Substantial project packages have been issued in English and Polish, with controlled repositories, formal progress reports, action logs, drawing registers, meeting minutes and contractual reporting. Procurement documentation has also required coordination with Polish and European procurement requirements alongside UK construction and statutory processes.

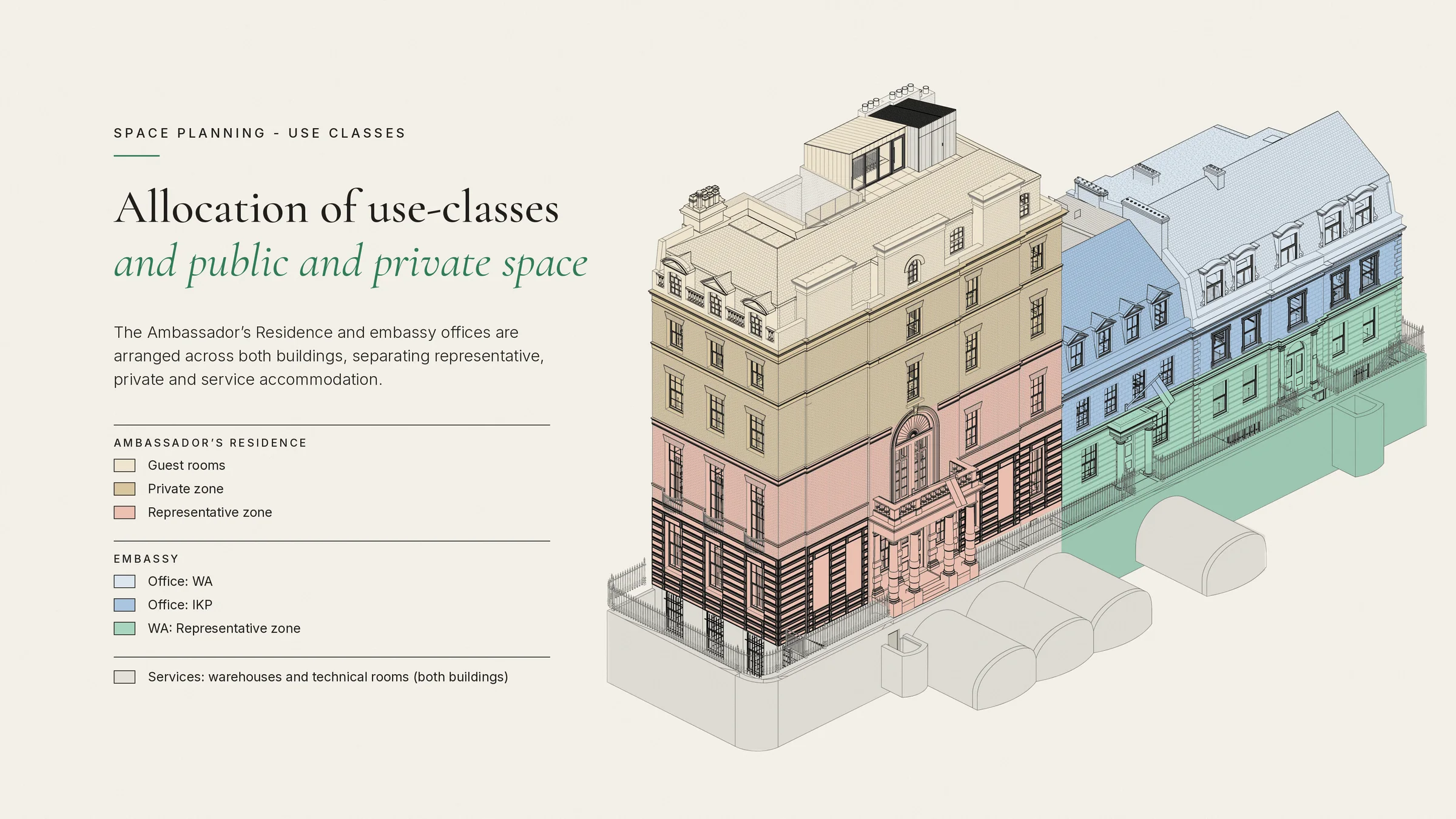

The project is unusual in having to accommodate formal diplomatic representation, private residential life, working offices and public-facing cultural activity within the same connected estate. That affects almost every discipline. Security, fire strategy and circulation must distinguish public, staff, guest and private areas. The representative spaces at 34 Portland Place must retain the architectural formality of the historic house while functioning for contemporary diplomatic events, while the Cultural Institute at 73 New Cavendish Street must accommodate public engagement, exhibitions and multifunctional uses while sharing infrastructure with secure diplomatic functions. The design therefore needs to work at both ceremonial and everyday scales.
The central conservation principle is straightforward: understand what is genuinely significant before deciding what must be retained. Decades of intervention had altered both buildings. Some spaces contain important surviving Georgian fabric; others had been substantially changed during the 20th century. Scientific and documentary analysis has allowed the team to make those distinctions with considerably greater confidence. This evidence underpins proposals to reinstate historic room proportions, remove inappropriate later partitions, restore lost openings, reconstruct decorative features where archival evidence exists and route new building services through areas capable of accepting intervention. The July 2026 benefits schedule records proposals including restoration of the Georgian enfilade at 34 Portland Place, reinstatement of historic openings, removal of inappropriate partitions, recovery of original room proportions and reinstatement of a lost Adam-style ceiling from archival evidence.
The consultant register demonstrates the scale of the team assembled around the project, including architecture and project leadership (Cohanim Architecture), structural and conservation engineering (Alan Baxter Associates), MEP and sustainability (CHPK Services Engineering), fire engineering (CHPK Fire Engineering, with earlier specialist input), heritage (Michael Swords Studio), planning (Marrons), a specialist Building Control adviser, health and safety (Eton Group), Party Wall advice (The Party Wall Consultancy), historical paint analysis and plaster conservation specialists, timber diagnostics, acoustics (Venta Acoustics), drainage survey and CCTV specialists, point-cloud and measured survey (Geosight 3D), a specialist aerial surveyor for UAV/drone survey, fire-suppression and mist-system designers, quantity surveying (Trinity Construction Consulting), and specialist lift manufacturers and consultants. The current consultant register contains around fifty named individuals across the project's various phases.
The project commenced on 3 February 2025. RIBA Stages 1–2 established the brief, building condition, heritage significance, technical constraints and initial concept. RIBA Stage 3 developed the coordinated planning and Listed Building Consent strategy, supported by an extensive body of specialist evidence. During 2026 the project moved into Stage 4 technical coordination while the statutory, Freeholder, neighbouring-owner and Party Wall processes continued in parallel. The latest project records show continuing work through August 2026 on coordinated MEP, fire suppression, conservation materials, structural design, Freeholder and neighbouring-property matters. The project therefore remains ongoing, with the work completed so far representing the statutory, evidential and technical foundation for construction.
| Date | Matter | Achievement |
|---|---|---|
| 3 Feb 2025 | Project commencement | Commission commenced for the Republic of Poland |
| Feb 2025 | Initial building access | Keys, protocols, site visits and internal photographic surveys coordinated |
| Feb 2025 | Specialist procurement | Heritage, structural, fire, Party Wall, point-cloud, drone and other specialist consultants investigated and appointed |
| Feb 2025 | Party Wall strategy | Specialist Party Wall advice commissioned at an early stage and recommendation made to begin neighbour engagement before formal notices became programme-critical |
| Feb 2025 | Hazardous materials | Historic asbestos records reviewed; hazardous-material and damp/mycological advice coordinated |
| Feb 2025 | Point-cloud survey | Geosight 3D appointed to provide detailed spatial survey information |
| Feb 2025 | UAV survey | Drone survey commissioned with relevant flight approval |
| Feb–Apr 2025 | RIBA Stages 1–2 | Multidisciplinary analysis completed covering architecture, heritage, structure, MEP, fire, H&S, Party Wall and feasibility |
| Apr 2025 | Stage 1–2 Report | Comprehensive multidisciplinary report issued for the 2,000+ sqm estate |
| Apr 2025 | WCC pre-application | Westminster officers undertook a site visit and initial statutory engagement progressed |
| 2025 | Heritage research | Archival drawings, historic permissions, room significance, condition and morphological analysis developed |

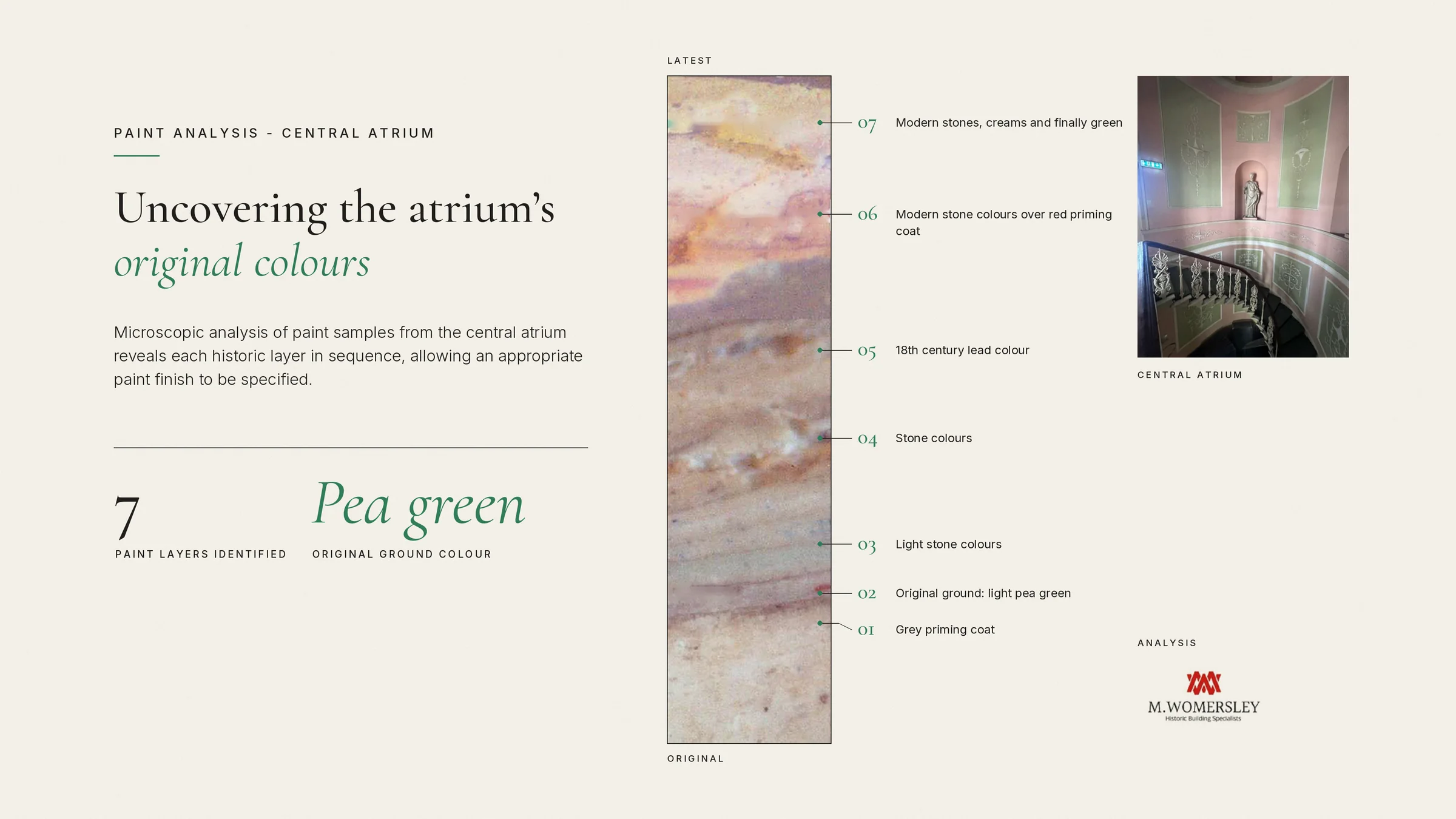

| 2025 | Specialist material analysis | Historic paint, mortar and timber investigations commissioned as part of evidence-led conservation strategy |
| 2025 | Fire engineering | Existing means-of-escape conditions reviewed across 34 PP, 73 NCS and adjoining 36 PP |
| 2025 | Freeholder strategy | Licence to Alter engagement initiated with Howard de Walden Estate |
| 2025 | Party Wall assessment | Multiple potentially notifiable works identified across neighbouring ownership interfaces |
| 5 Nov 2025 | Formal Party Wall report | Specialist report issued assessing statutory triggers and affected adjoining ownerships |
| 5 Nov 2025 | Georgian Group | Formal specialist heritage response recognised the quality of the project's research and identified heritage benefits |
| 13 Nov 2025 | Stage 3 preview | Bilingual English / Polish planning and LBC preview package issued to the Contracting Authority |
| Oct–Nov 2025 | Fire strategy | Water-mist strategy selected following multidisciplinary fire / heritage assessment |
| Late 2025 | WCC disruption | Statutory process actively managed through Westminster's significant IT / cyber disruption |
| Jan 2026 | RIBA Stage 3 | Coordinated planning, heritage, structural, MEP and fire packages developed toward submission |
| Feb 2026 | Planning / LBC | Extensive application documentation assembled, including planning, heritage, fire, structure, material analysis and technical evidence |
| Feb 2026 | WCC meeting | Contracting Authority and design team met directly with Westminster to progress statutory and programme matters |
| Feb 2026 | Building Control | In-principle support recorded for water mist subject to equivalent-performance and heritage justification |
| 2026 | RIBA Stage 4 | Detailed architectural, structural, MEP and fire coordination commenced |
| Spring 2026 | Freeholder / neighbour work | Means-of-escape, Licence to Alter and adjoining-occupier negotiations continued in parallel |
| Jun–Jul 2026 | Stage 4 coordination | MEP, risers, AHU, smoke extract, accessible WC, fire compartmentation, lift and structural information coordinated |
| Jul 2026 | Heritage benefits schedule | Consolidated case prepared for WCC setting out restoration, accessibility, fire-safety and long-term conservation benefits |
| Jul–Aug 2026 | Freeholder / legal coordination | 36 Portland Place information developed for continued discussion with Howard de Walden Estate and legal teams |
| Aug 2026 | Fire suppression verification | Additional independent regulatory review undertaken of the proposed water-mist system |
| 2026–ongoing | Technical / statutory delivery | Stage 4, WCC, Freeholder, Party Wall, neighbouring-property and procurement work continues |
